When to electrify your heating

The challenges with electrification and when best to tackle them.

An ArcSett insight for industrial and manufacturing businesses.

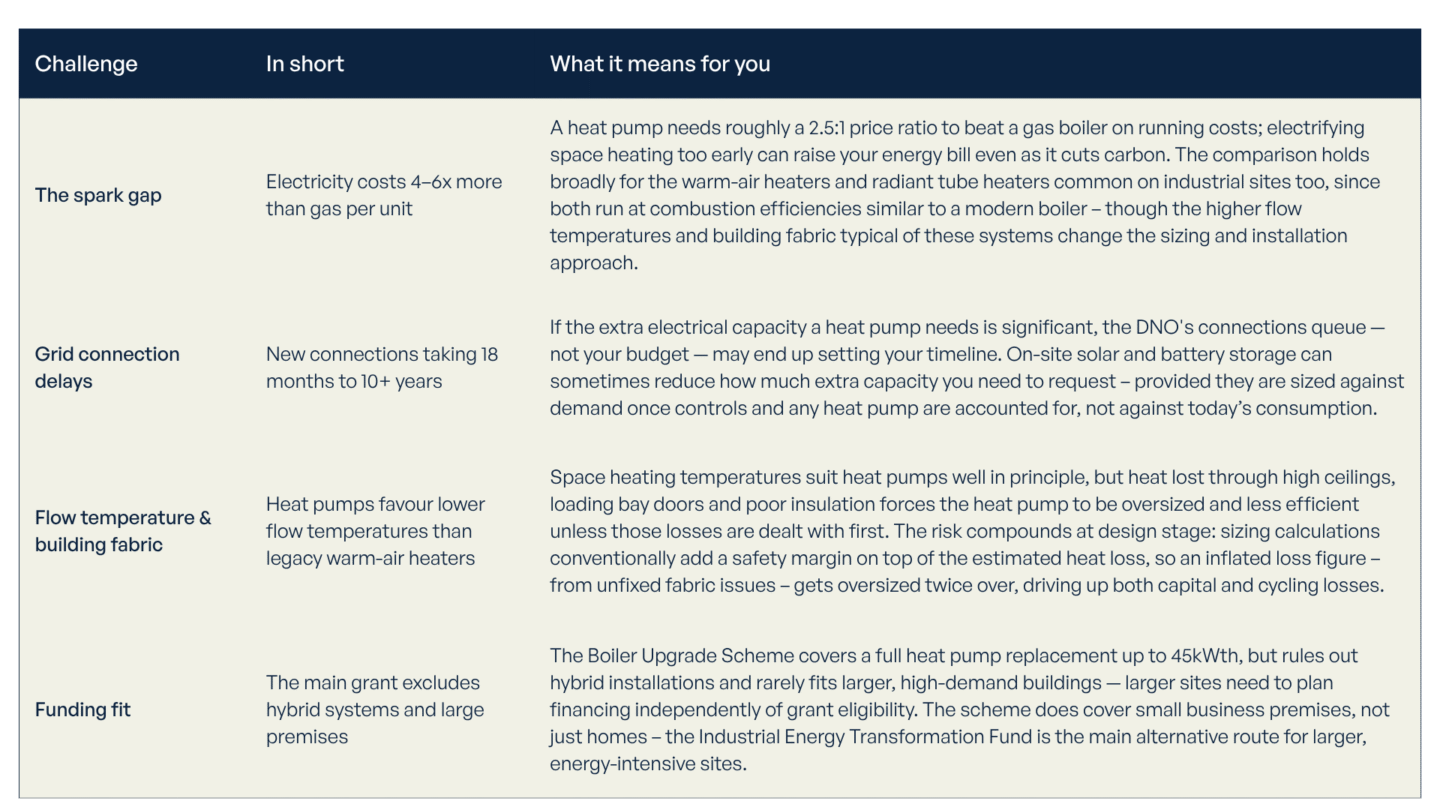

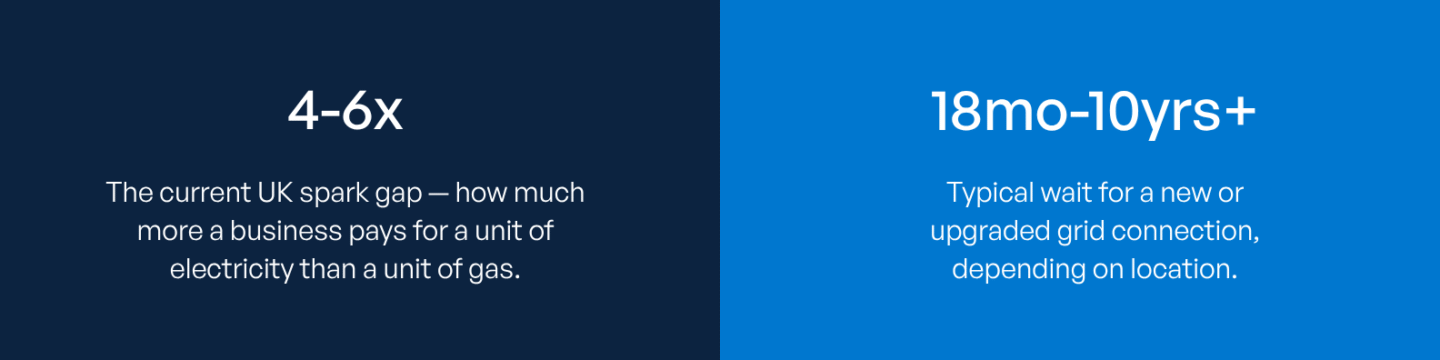

None of these rules out electrification. But each one changes the timing, and ignoring any of them tends to show up later as an unplanned cost.

1. It right-sizes the investment. A heat pump only needs to be big enough for the heat that is genuinely required once losses through doors, roofs and poor insulation are under control – not the inflated demand of an unmanaged building. That lowers the ongoing running cost with certainty, and – where losses like open doors, unoccupied heating and stratification were previously inflating the design calculation – can also lower the heat pump’s rated capacity and the electrical capacity you need to request from your DNO.

2. It builds the business case. Granular, site-level usage and temperature data is exactly what is needed to model a credible design and business case, support a grant or funding application, and get a grid connection request moving through the queue.

3. It carries forward into a hybrid setup. Because ArcSett’s control solution already integrates with gas, electric and oil-fired plant, the same system trimming your current gas load today becomes the dispatch layer for a hybrid site tomorrow — automatically running on whichever source is cheaper and lower-carbon at any given moment, with no need to replace the control layer as the heat source changes. This holds regardless of which fuel is doing the work on a given day – without energy controls, any heating estate, gas, electric or oil-fired, becomes harder to manage and less efficient to run.

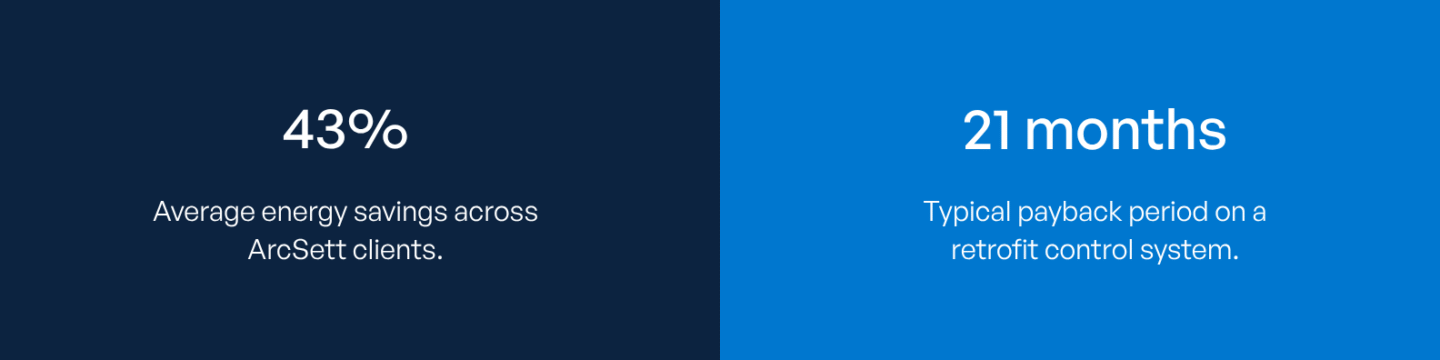

4. It builds the investment fund. A retrofit control system typically pays for itself in around 21 months and strips an average 43% off consumption – across ArcSett’s client base. Because those savings start accruing from month one, installing controls first — rather than in parallel with a heat pump — lets a business set the freed-up spend aside as part of the funding case for the heat pump project that follows, rather than having both investments compete for the same budget at once.

  1. Understand your position first. Use the data the control system has already gathered to how you are using your energy currently, how carbon-intensive that spend is, and where the remaining demand sits — this evidence, not a generic timeline, should drive every decision that follows.

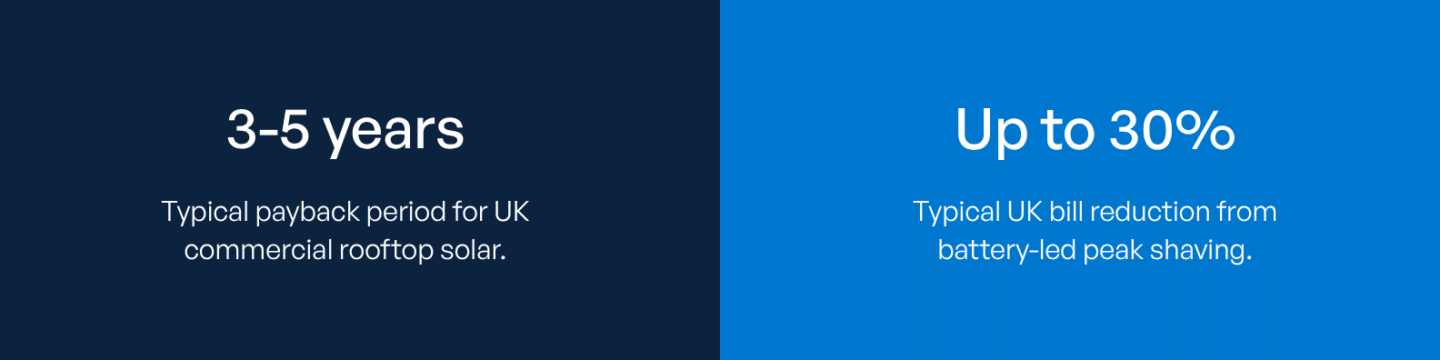

  2. If capital allows and carbon is the priority, electrify sooner. Businesses able to fund the move now, and prioritising decarbonisation over short-term running costs can commit to a heat pump even while the spark gap is unfavourable — particularly when it is paired with the ongoing savings from energy controls and, where the site allows, on-site solar and battery storage to offset some of the running-cost premium from day one.
  3. If cost control is the priority, phase it. Where payback period and cash flow matter more than pace, a hybrid, control-led approach lets the building keep saving and decarbonising; in the meantime, the ongoing savings from the controls themselves help build the investment case for what comes next –  adding further electric heating capacity, solar and battery as the economics and available funding align.
  4. Check the funding fit before committing. The Boiler Upgrade Scheme suits a full replacement on a smaller building, but its 45kWth cap and full-replacement condition rule it out for many larger sites and for any hybrid approach — plan financing accordingly rather than assuming grant eligibility. Tax relief can help regardless of route: heat pumps, controls, solar and battery storage installed by a business typically qualify for the Annual Investment Allowance, letting the full cost to be deducted from taxable profit in the year of purchase, with full expensing offering a further route for limited companies on qualifying equipment.
  5. Apply for the grid connection early. If the added heat pump capacity across the site is material, sizing the request against demand net of any planned solar or battery. The queue, not your budget, is increasingly the limiting factor, and applications submitted now may still take years to clear.

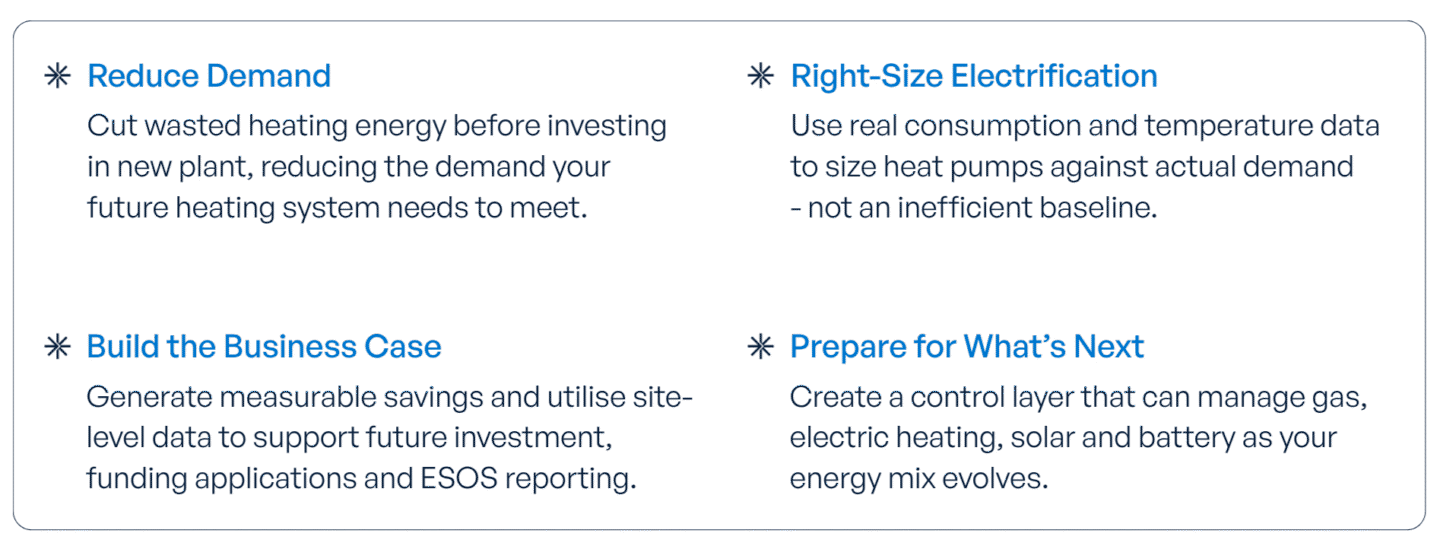

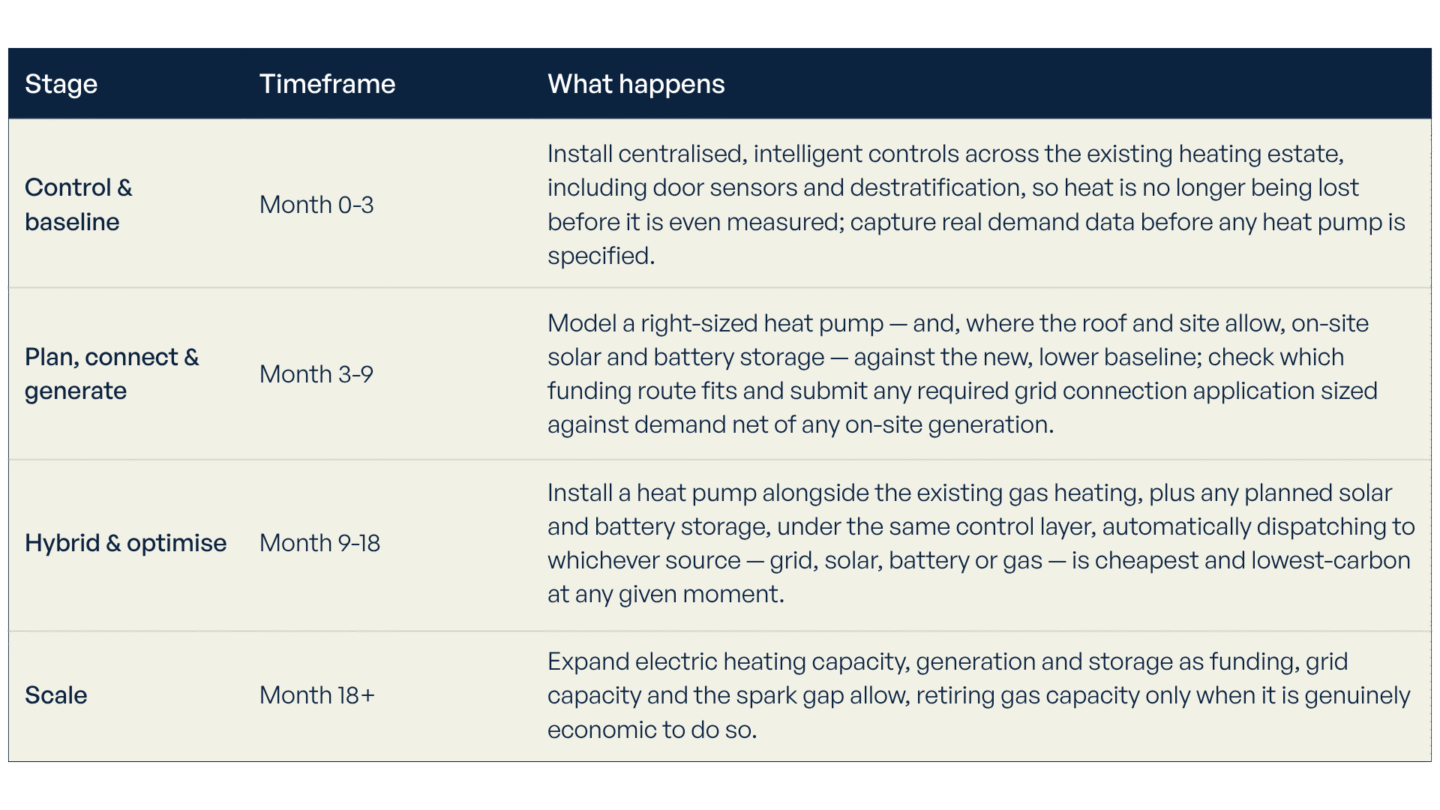

Sequencing determines whether electrifying your heating is an affordable transition or an expensive one. A practical four-stage approach:
